Construction Update #16 – Countdown to Completion: $25M Amenity Complex!

June 9, 2025

Big things are taking shape at The Headquarters Amenity Complex in Solterra, Texas! This highly anticipated $25M hub of recreation and relaxation is quickly becoming a reality, offering a resort-style experience unlike anything else in the region. With three signature pools—an activity pool, a kiddie pool, and an adult pool with private cabanas—plus a dramatic sand beach entry to the lake, the complex promises a coastal vibe right in the heart of Texas.

As we move closer to completion, here’s an inside look at the latest construction milestones.

Dream Destination

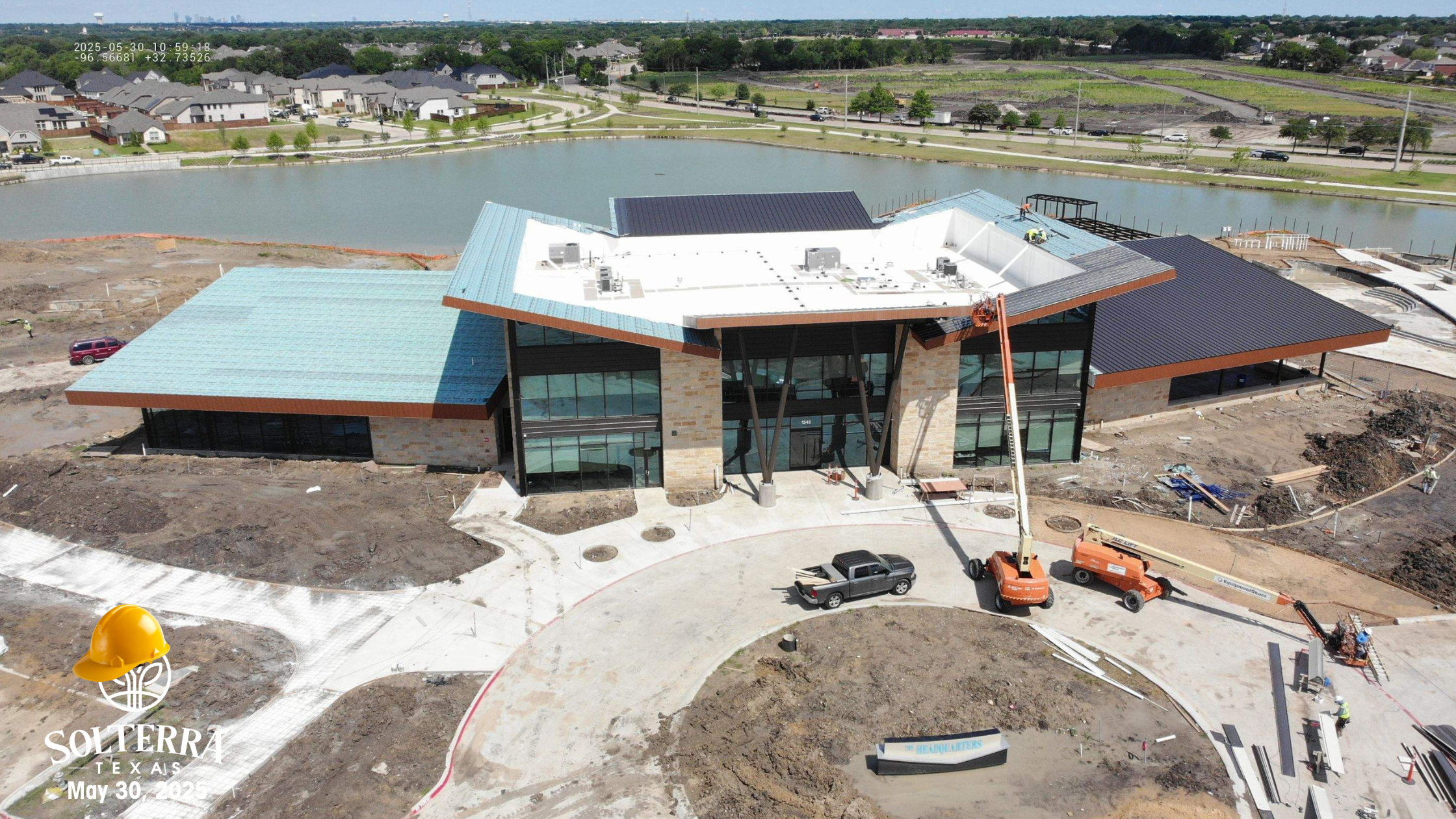

The Activity Pool

May 27th: Pool plumbers jackhammered the pool deck to investigate and resolve leaks while electricians prepped exterior lighting.
May 29th: Backfilling began for electrical conduits, and the equipment pad was adjusted. Plumbers continued troubleshooting underground leaks.
May 30th: Electricians ran wire to pool light poles and began cleanup near pool bathrooms.
June 5th (scheduled): Final forms and rebar will be placed around the adult pool, with inspections and conduit backfill planned.
June 6th (scheduled): Electrical systems including lights, plugs, and switches will be finalized, pending final inspection.

The Kiddie Pool & Cabana

May 29th: Cleanup efforts began near cabana #3 following recent rains. Crews also worked to reset rebar and forms for surrounding sidewalks.
May 31st: Hughs and Son poured 50 yards of concrete for the west sidewalk near the cabanas, signaling key progress on walkways.
June 5th (scheduled): Concrete pours will continue—approximately 60 yards around cabana 3 and stair footers at the nearby bar area are planned.

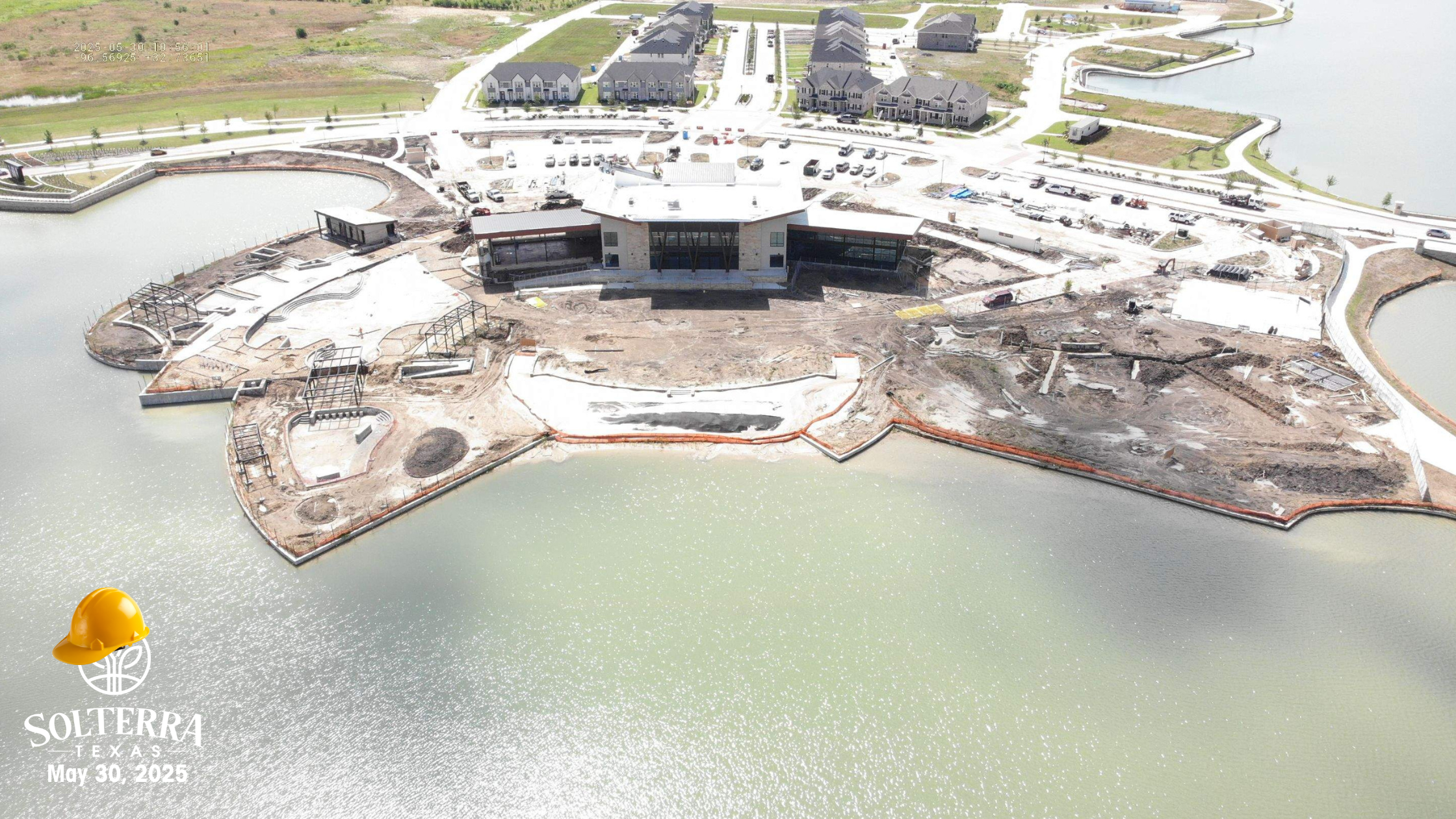

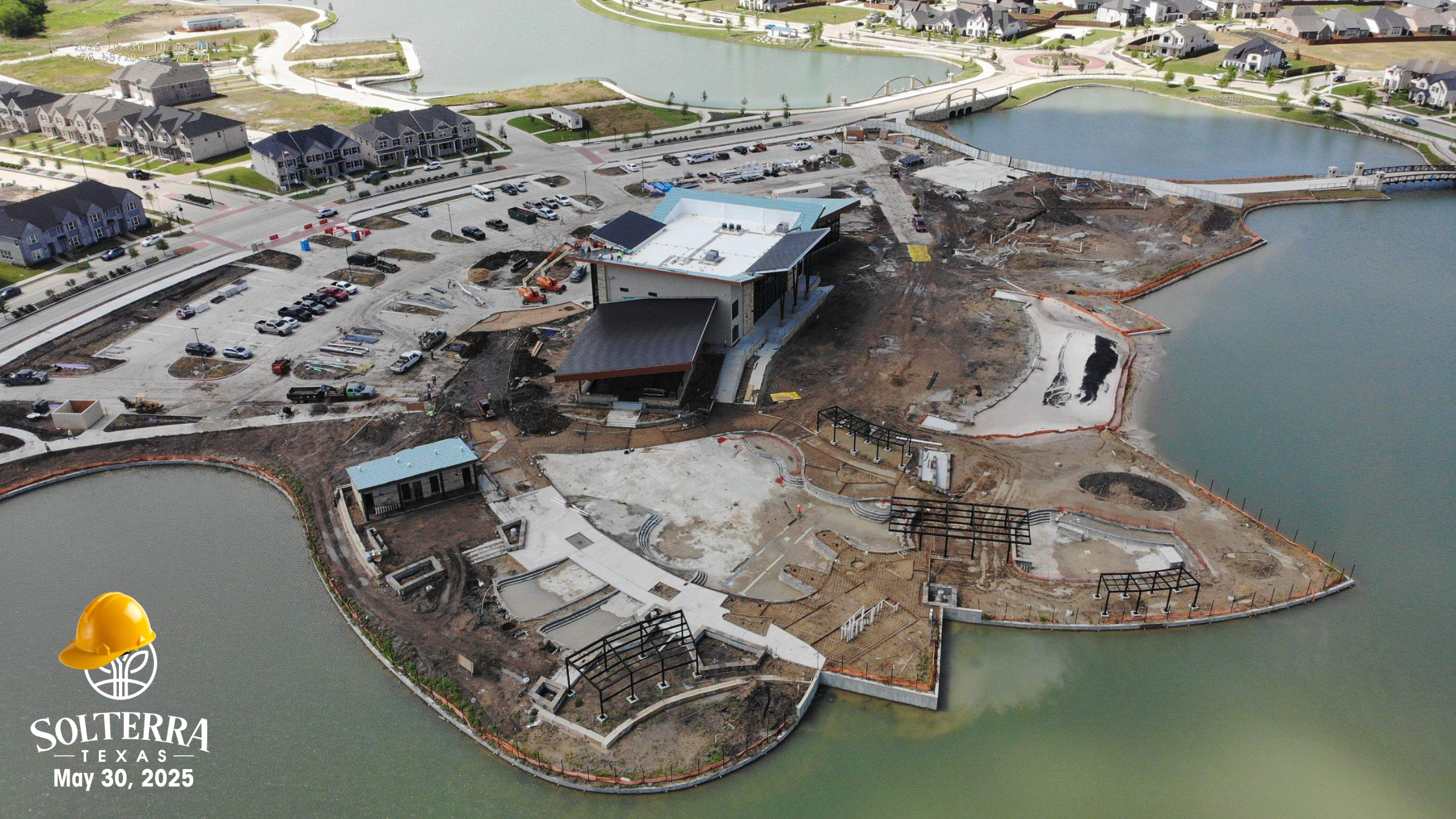

The Sand Beach Entry

The crown jewel of Solterra’s aquatic offerings is undoubtedly the lake with a sand beach entry. This stunning feature will bring the serene ambiance of a beach getaway right to Texas.

Lake activities will include:

  • Kayaking and Canoeing
  • Swimming
  • Paddleboarding
  • Catch and release fishing

May 28th–30th: Irri-Tech worked on trenching and laying irrigation lines near the east parking lot by the pond—essential groundwork for the lakefront and beach areas.
June 3rd–6th (scheduled): Layout continues for tree and drainage placement on the south side of the parking lot, extending westward. Underground conduits by the adult pool will be finalized, and lighting in Area 2 will be completed.

Final Touches Coming Soon

Here’s what to expect as construction wraps up:

  • June 2nd–6th: Interior punch list work across paint, flooring, and millwork
  • June 3rd: Pouring sidewalks on the east side of the complex
  • June 5th–6th: Final electrical inspection and fire safety walkthroughs
  • June 7th–8th: No scheduled work—site will be prepped for next week’s progress
  • Irrigation installation will continue near the dog pool
  • Street and parking lot cleanup will begin in front of the amenity center

Grand Opening Event!

As construction crews check off each critical detail, the anticipation for Solterra’s showstopping amenity complex continues to build. From shaded cabanas to shimmering pools and lakefront adventures, this $25 million investment is shaping up to be the crown jewel of the community.

Get ready for an unforgettable summer of fun, relaxation, and waterfront living—all just steps from home.

Stay tuned—we’re almost there!
